What Is Concrete Leveling (Polyurethane Foam Lifting)?

How foam concrete lifting works — closed-cell polyurethane, injection ports, void filling, which surfaces qualify, and what it will not fix.

Updated September 16, 2026 6 min read

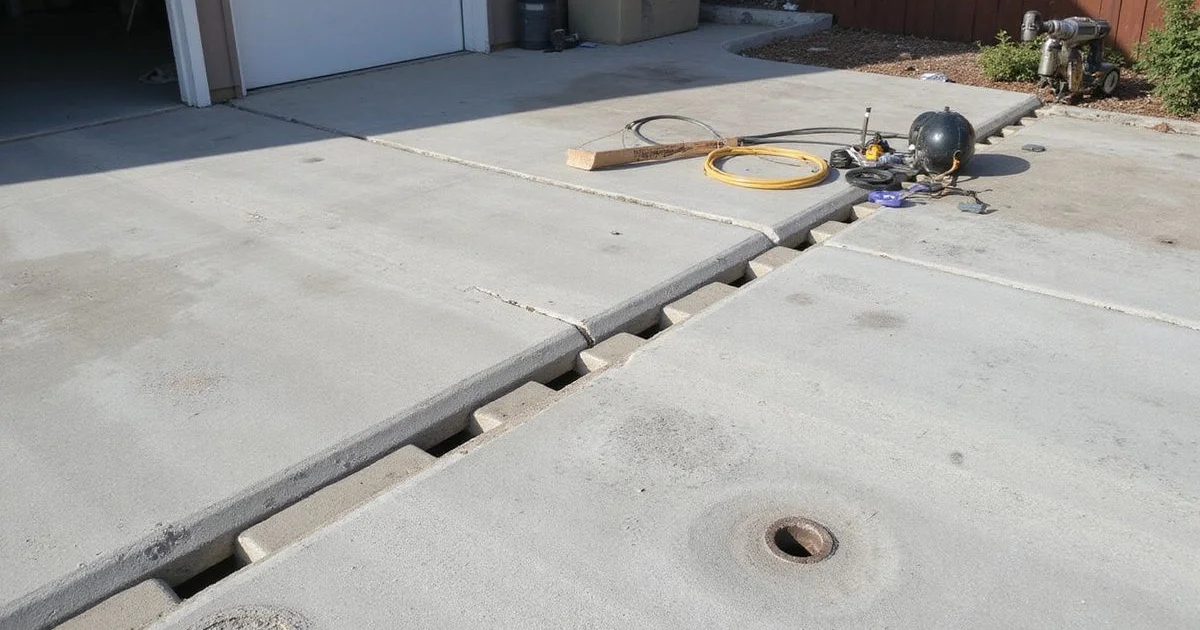

Small injection ports drilled in a row across a settled concrete driveway slab

The problem it solves

Concrete flatwork sits on prepared ground. When that ground moves, erodes, or consolidates, a void opens beneath the panel and the concrete drops into it.

You end up with a driveway panel lower than its neighbor at the joint, a sidewalk with a lip that catches a toe, or a patio that has tilted back toward the house — which is worse than untidy, because it now directs water at your foundation.

Levelling raises the panel back to position by filling the void beneath it.

How the process works

Assess the panel. Thickness, condition, cracking, and what is likely underneath. Not everything should be lifted.

Drill ports. Small holes are drilled through the concrete at intervals across the area being raised.

Inject. A two-part closed-cell polyurethane polymer is pumped through a port. It reacts and expands beneath the slab, first filling the void and then developing enough pressure to lift.

Monitor the lift. Height is watched continuously as material goes in, and injection moves between ports to control where the panel rises. The goal is a controlled, even lift, not a fast one.

Stop at target. Including — importantly — checking the resulting slope rather than only the joint height.

Patch the ports. Filled with a cementitious material. They remain slightly visible up close on most surfaces.

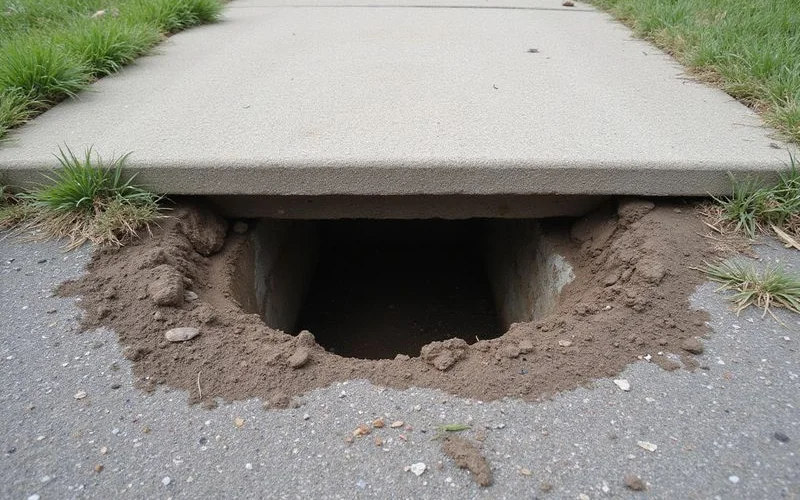

Void visible beneath the edge of a settled concrete sidewalk panel where subgrade has washed out

Why the material suits the job

Closed-cell polyurethane has three relevant properties.

It is light. The subgrade beneath a settled panel has already demonstrated it cannot carry what was there. Adding a heavy fill material risks repeating the failure; foam adds very little weight.

It expands. A small injected volume fills a large void, which is what allows the work to happen through small ports rather than by excavating.

It cures fast. Usable strength develops quickly, so the surface returns to service the same day in most cases.

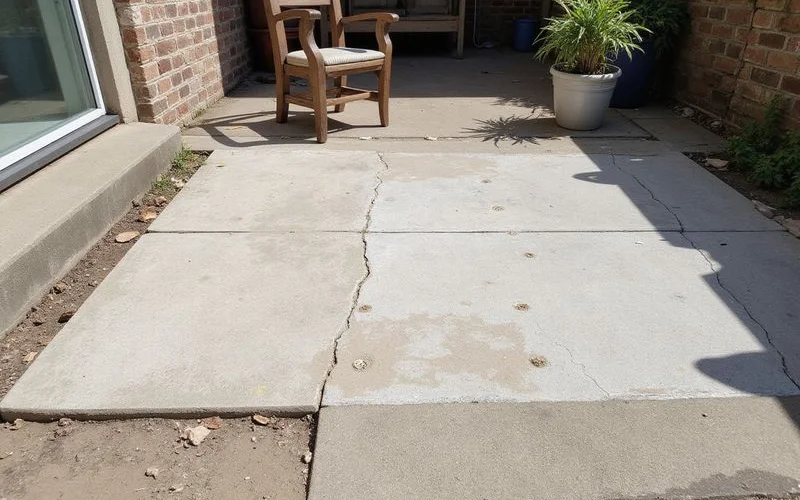

Level concrete patio slab after foam leveling with the joint flush against the adjoining panel

What qualifies, and what does not

Good candidatePoor candidate
Panel settled largely as a unitBroken into multiple pieces
Minimal crackingExtensive cracking through the panel
Adequate thicknessUnusually thin concrete
Surface otherwise soundHeavily spalled or deteriorating
Subgrade cause resolved or resolvableActive washout not being addressed
Remaining service life worth extendingConcrete at the end of its life anyway

Where a panel falls in the right-hand column, replacement is usually better value, and a contractor who says so is doing you a favor rather than turning down work.

What it will not fix

Your house foundation. Different problem, different work. See concrete leveling for how we keep the two separate.

The cause of the settlement. If water is washing subgrade out from under an edge, lifting the panel buys time. Fixing the water is the actual solution — see drainage solutions.

A cracked panel’s structural condition. Lifting does not repair concrete. See cosmetic crack repair versus structural repair.

Drainage, unless slope is treated as part of the goal. Two flush panels that both fall toward the house have solved the appearance and none of the problem.

What to ask before agreeing

Is my panel a suitable candidate, and why? What is likely to have caused the settlement here? Is that cause still active, and what would address it? What will the port patches look like on this surface? What slope will the finished panel have?

That last question is the one most often skipped, and on a patio next to a house it is the one that matters most.

FAQ

Questions about this topic

How does foam lifting actually raise concrete?
Small ports are drilled through the settled panel and a closed-cell polyurethane polymer is injected beneath it. The polymer expands as it reacts, filling the void that allowed the panel to drop and then, as more material is introduced, exerting enough upward pressure to raise the concrete. Height is monitored continuously so the lift stops at the target rather than overshooting. The ports are then patched. The polymer is light, which matters — it does not add significant weight to the subgrade that failed in the first place.
What flatwork can be leveled this way?
Supported, non-structural concrete: driveways, sidewalks, patios, pool decks, garage approaches, steps, and landings. The essential requirement is that the panel is sound enough to be lifted as a unit. A panel that has settled fairly evenly with minimal cracking is an excellent candidate. One broken into several pieces, heavily spalled, or unusually thin is not, because the pieces move independently and the result is untidy at best.
Can foam fix my house foundation?
No. Flatwork leveling raises concrete that is not carrying your house. Foundation repair addresses the slab or pier system that is. Injected material does have applications beneath a structural slab — typically filling voids after a lift rather than performing the lift — but that is a different operation within a different scope. If a proposal blurs the two, ask specifically which one you are buying.
How long does it take and when can I use the surface?
Most residential areas are completed in a few hours. The polymer reaches usable strength quickly, so foot traffic is usually possible almost immediately and vehicle traffic shortly afterwards — considerably faster than replacing the same panel, which involves demolition, forming, pouring, and a cure period.
Will the lift last?
The polymer itself is stable and does not break down or wash away. What determines longevity is whether the cause of the original settlement is still active. Where the cause was one-off — consolidation of fill placed at construction — the result typically holds. Where water is still eroding the subgrade under an edge, the panel can drop again, and the honest recommendation is to address the water as well.

Still have a question about your property?

Ask it directly. We answer quote requests within one business day, and we will tell you if the answer needs an on-site look rather than a guess.
